(044) 299 49 66

Construction progress as of 22 July 2024

22.07.2024

Was it hot in June? Construction was also hot, because the complex of works progressed day after day, where 3 sections of the complex were in parallel and the work on the underground parking lot La Manche was being finalized!

◽️ Section I

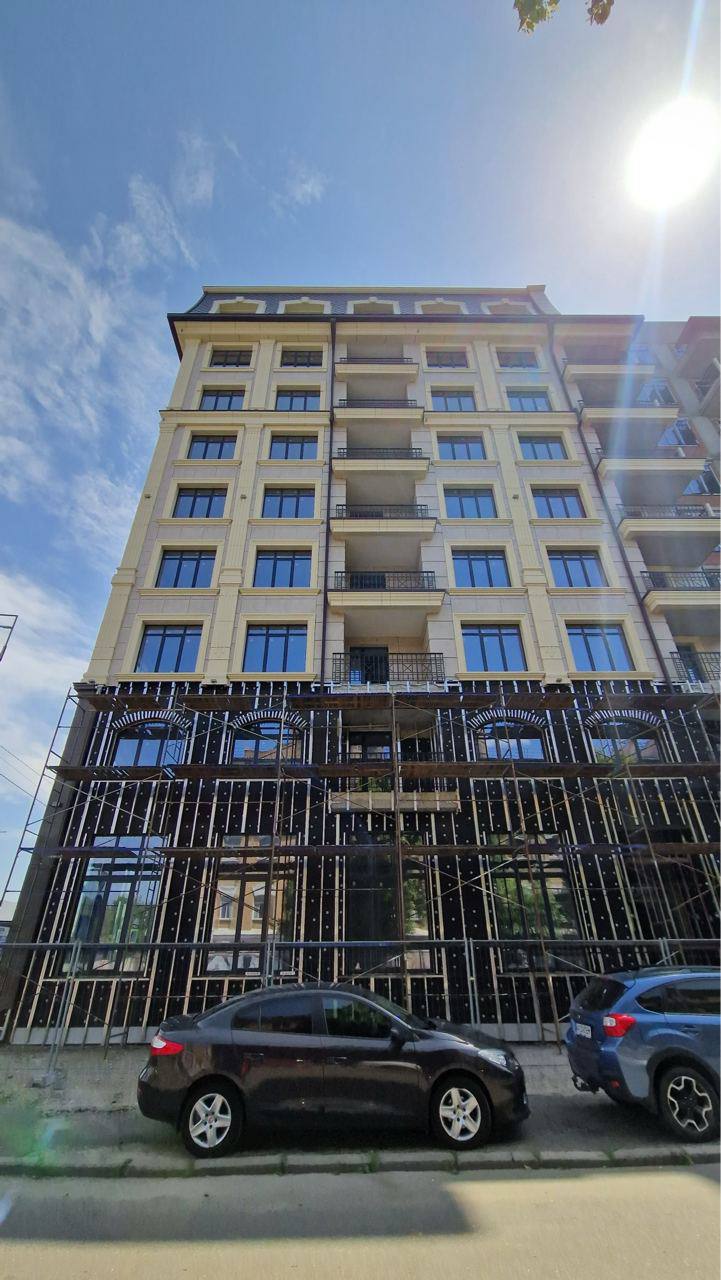

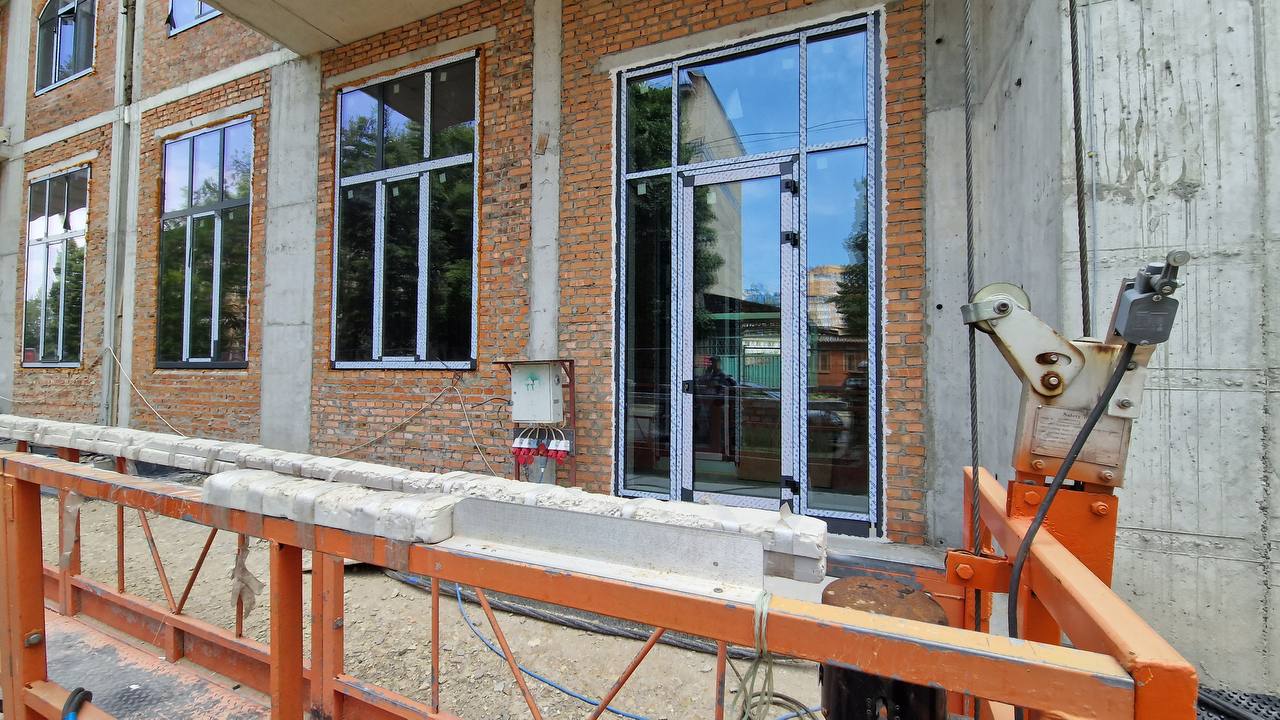

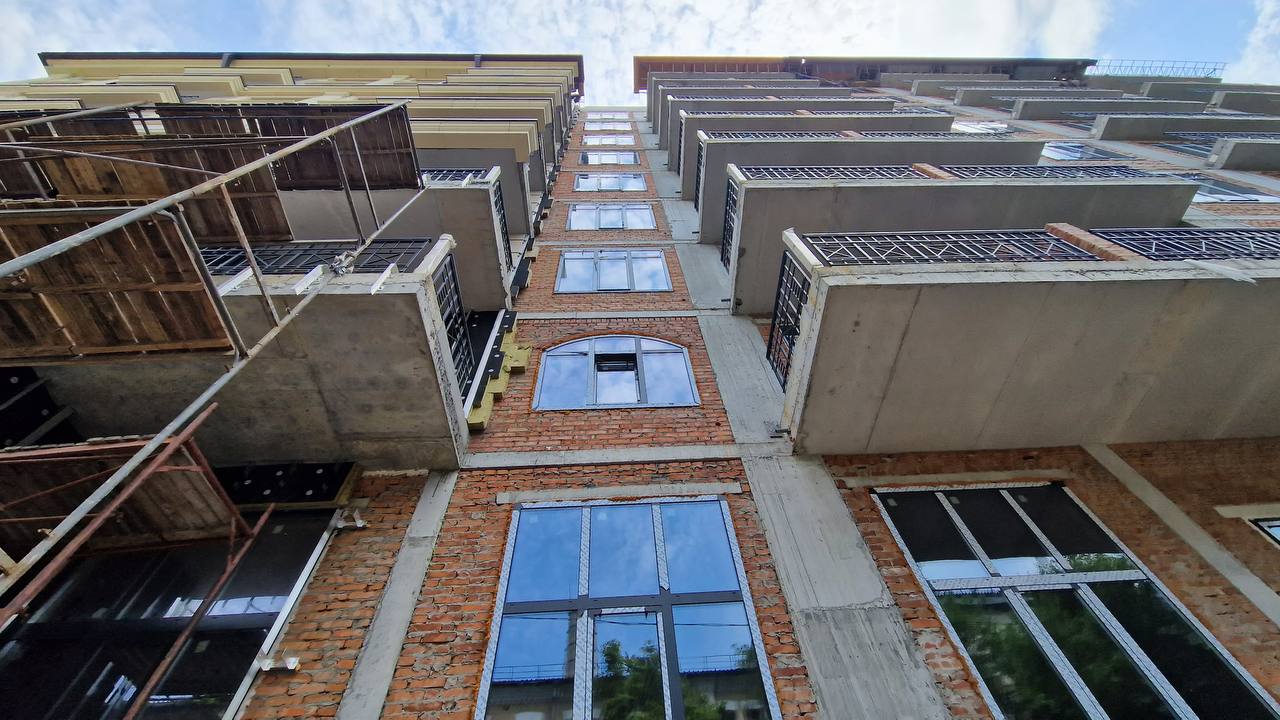

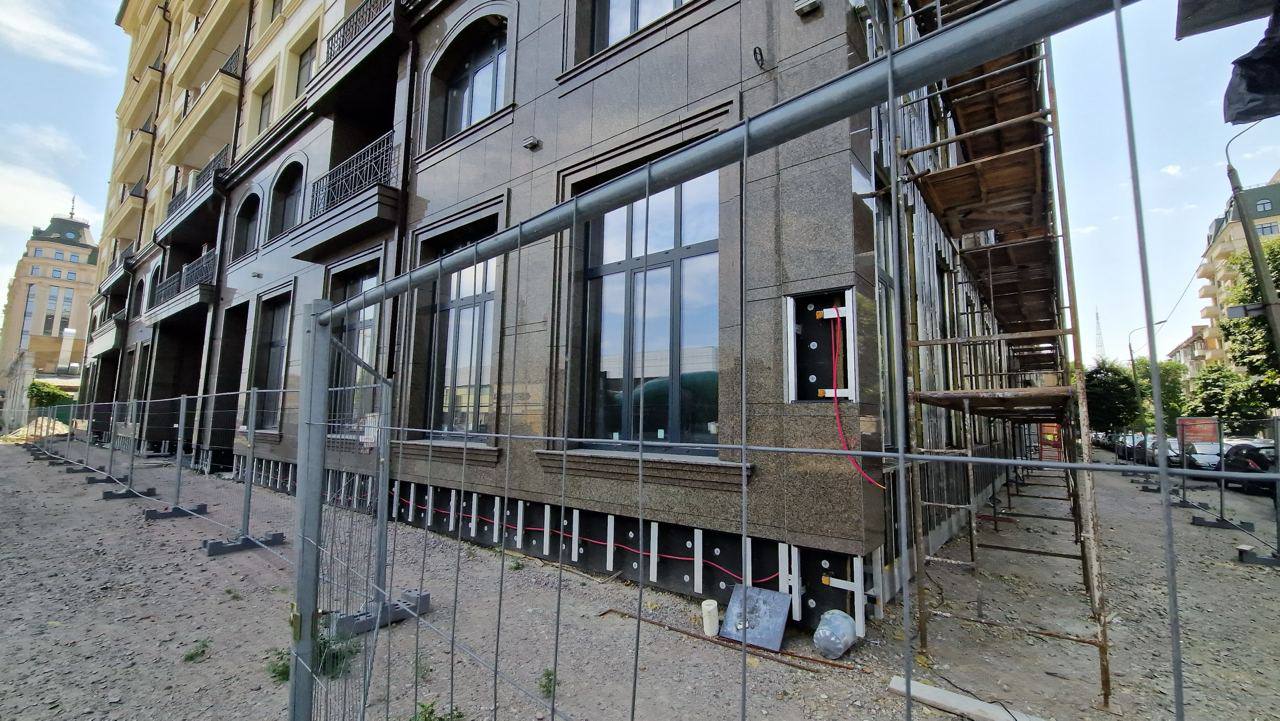

Window frames have been delivered and installation has begun, the first 10% has already been completed.

◽️ Section II

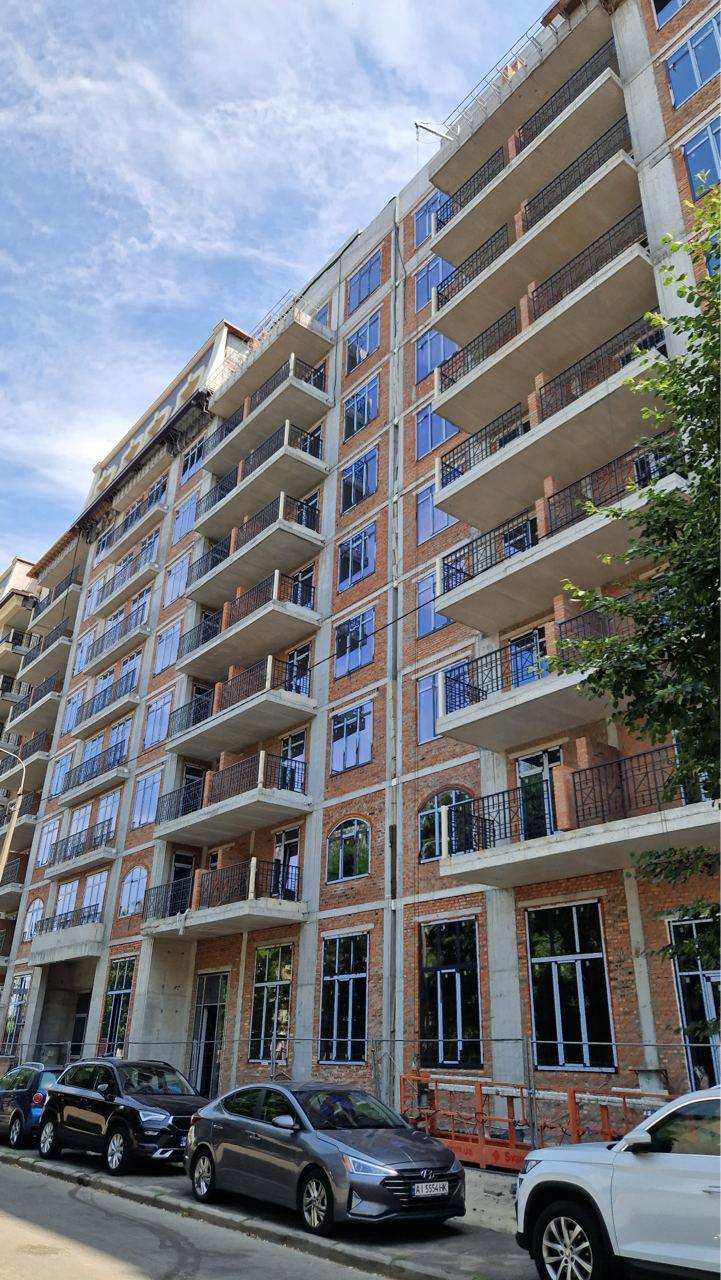

Finalized the installation of windows on the 2nd section of La Manche.

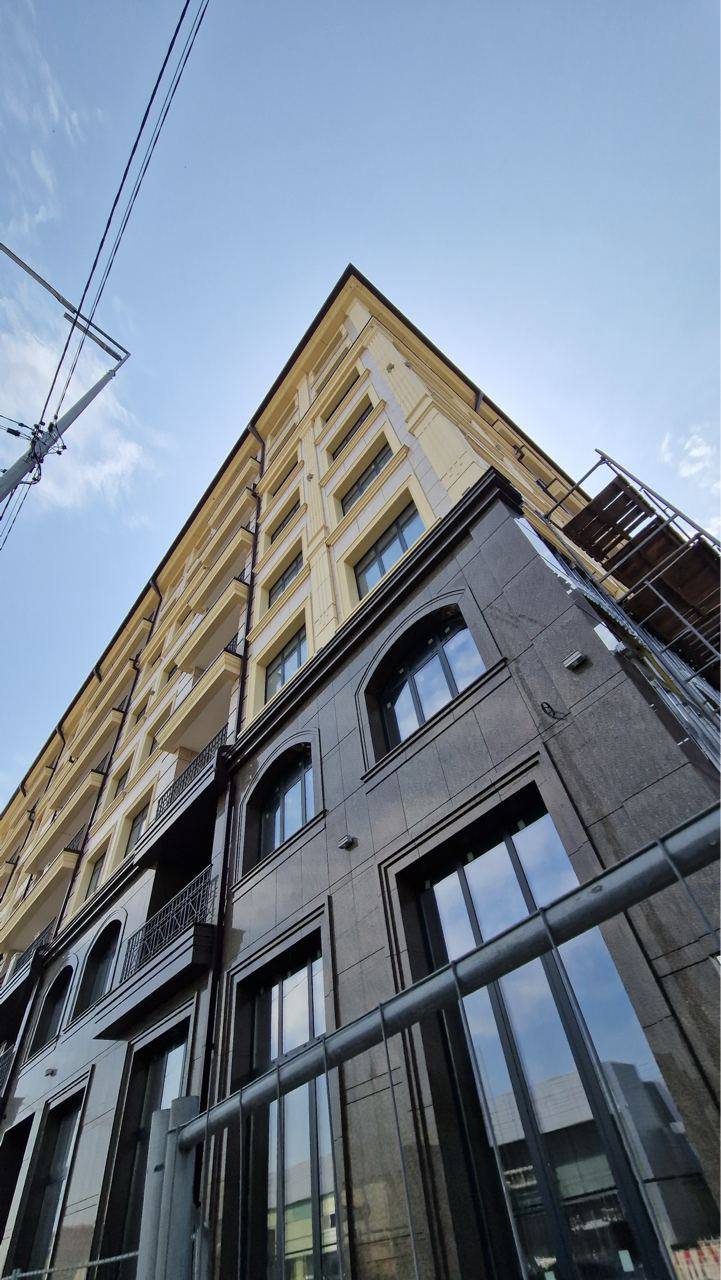

◽️ Section VII

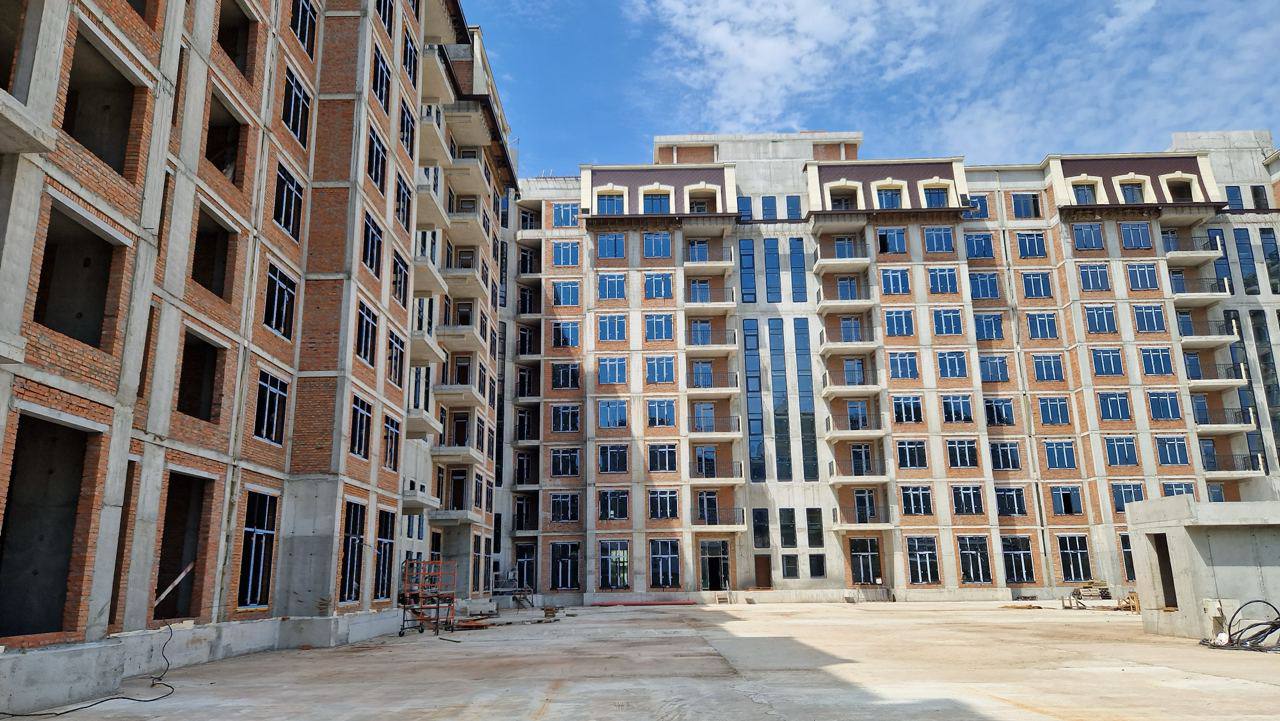

The floor screed in public areas has been completed, we are starting to lay tiles.

Parking

During the summer, we completed work on the underground parking lot of the complex, namely, we prepared a parking ramp for cars to enter. Monolithic walls, columns, crossbars are ready, as well as other work on the ramp - 100% readiness.

During this period, 50% of waterproofing works were also completed. Today, construction crews continue to complete the volumes.

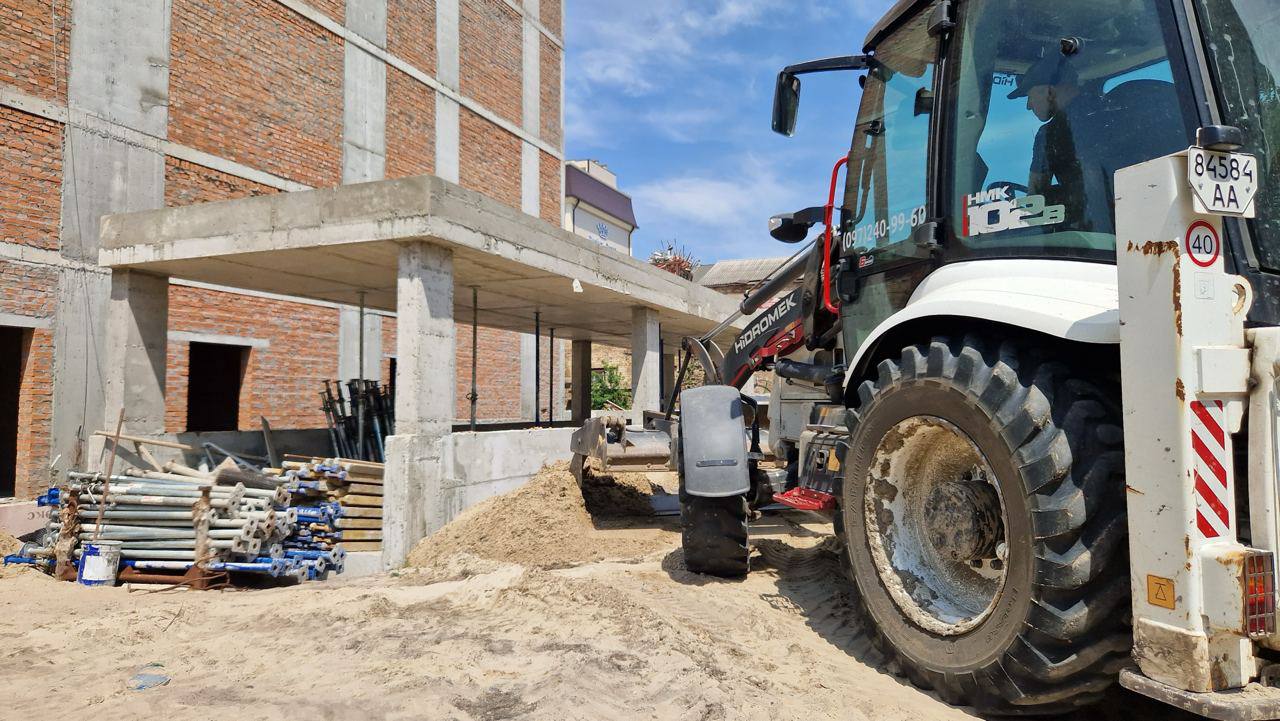

In parallel, excavation work was carried out to backfill the parking lot, where 550 tons of backfill were delivered.

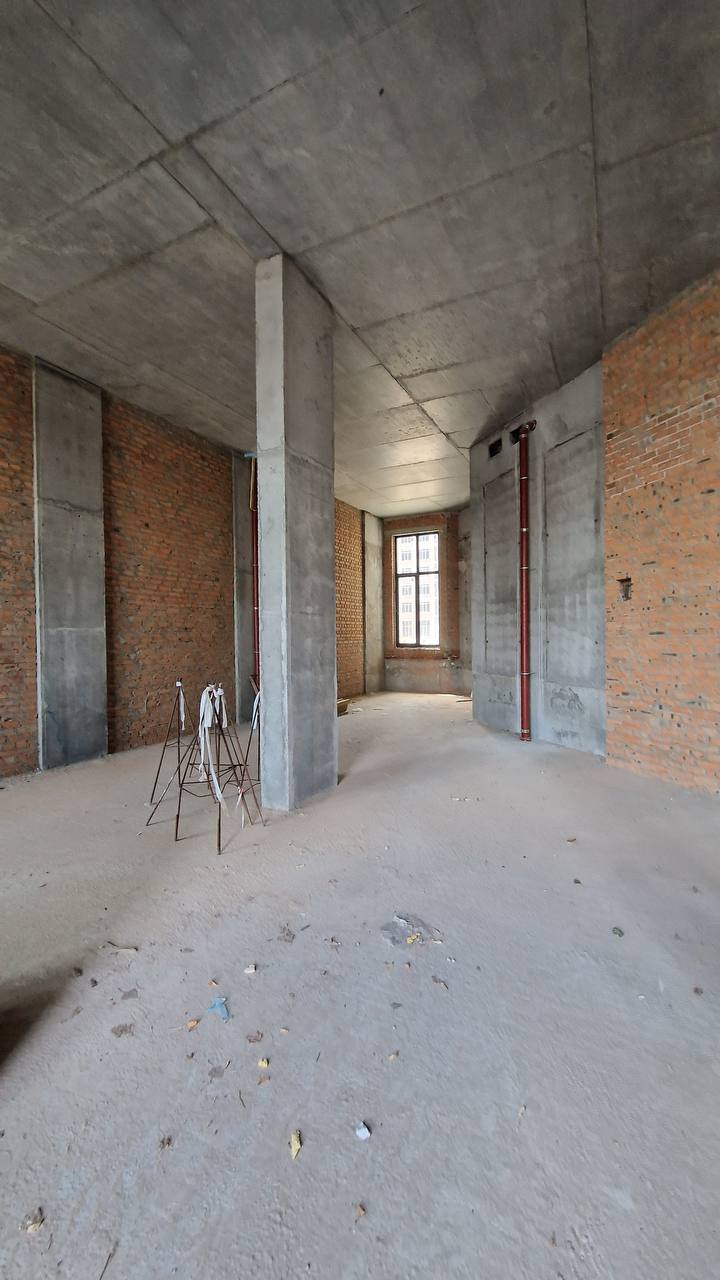

Internal works of the complex

To continue the work and allow new equipment to arrive, an access road was constructed, 31 road slabs were installed.

The brick wall on the site was dismantled, the area was cleared, and a temporary fence was installed.
