Construction diary La Manche от 04.06.2021

08
02

We tell you about the details of the construction of the LA MANCHE club house.

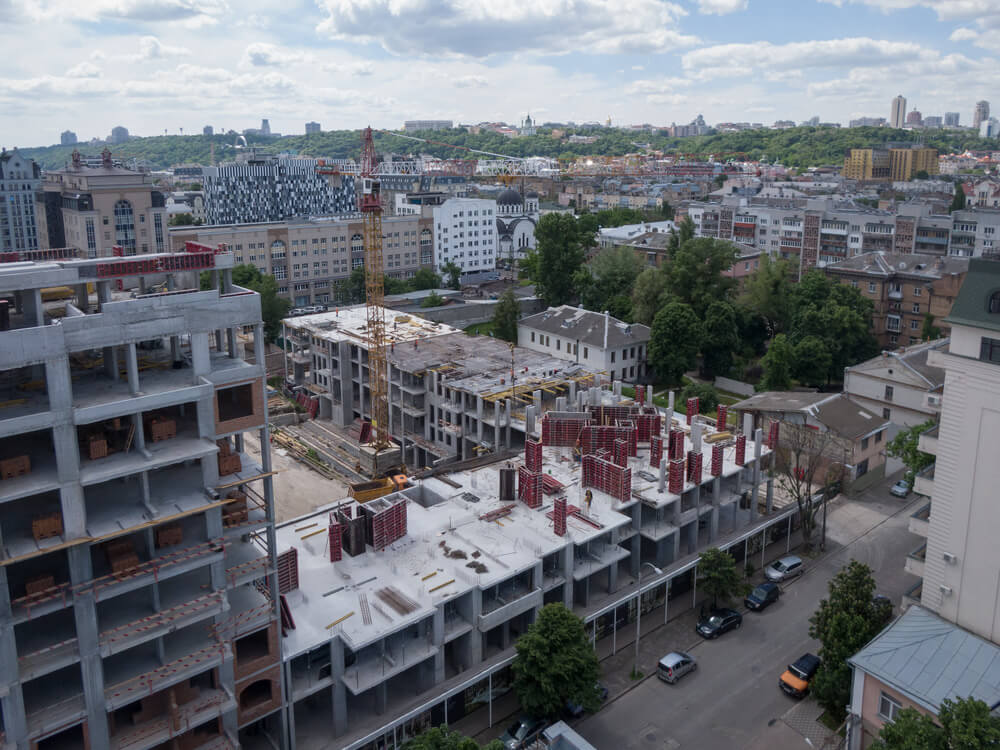

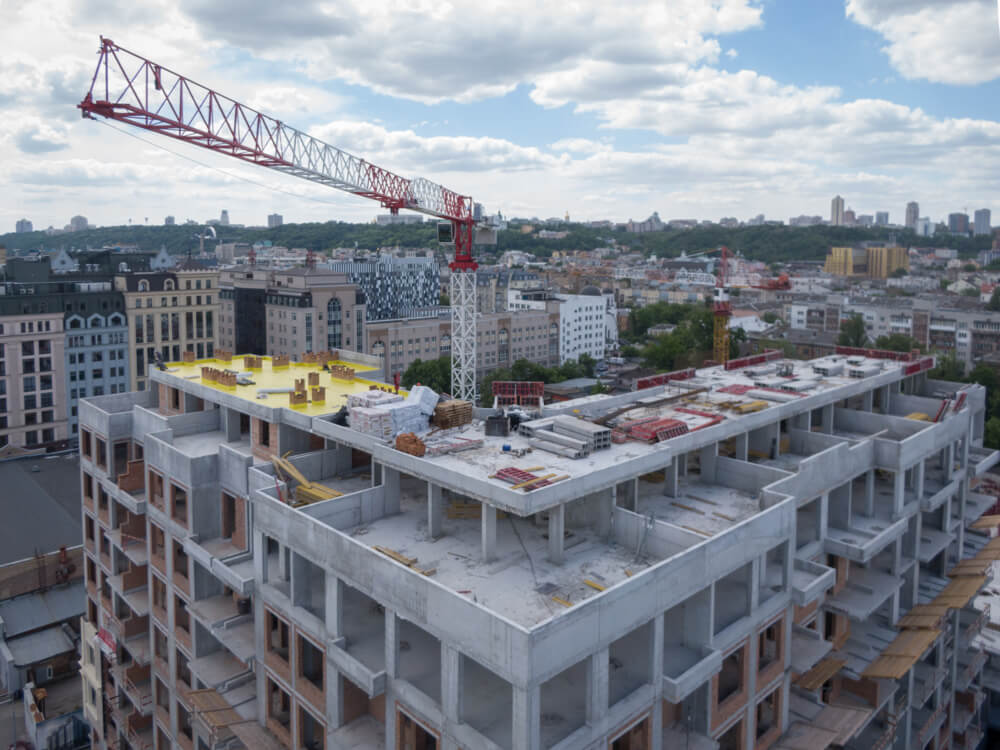

Section 1 - the floor slab above the 3rd floor is 100% complete.

Section 2 - floor slab over the 2nd floor and vertical elements over the 3rd floor are made. The reinforcement of the floor slab above the 3rd floor is 75% done.

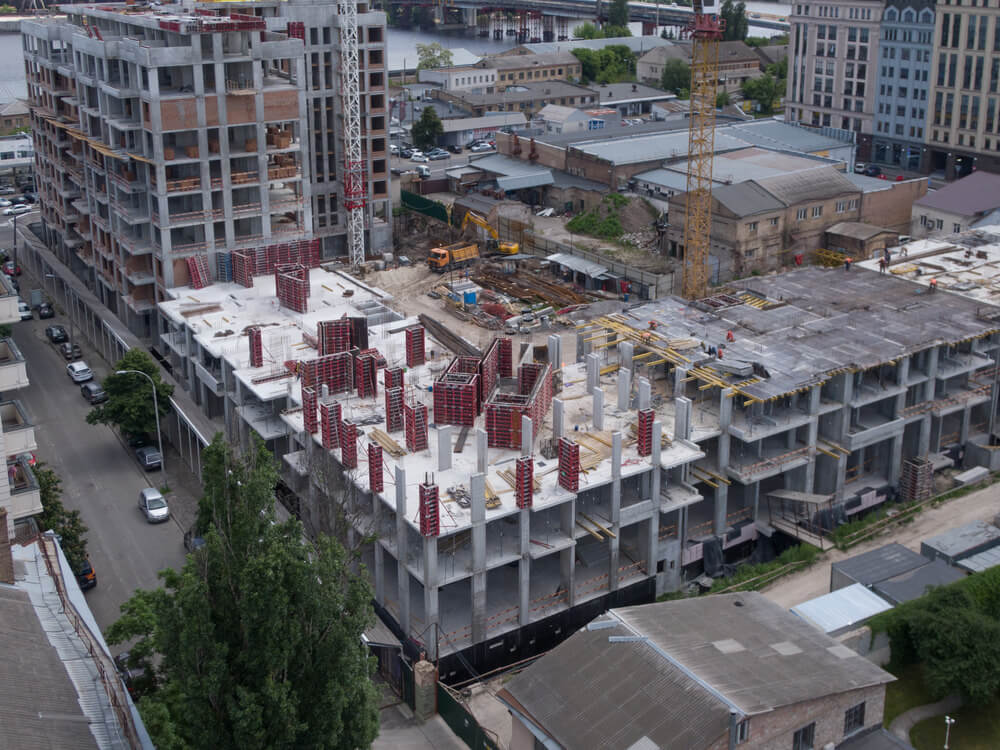

In section 3, we continue concreting the vertical elements of the 3rd floor. The installation of the formwork for the floor slab above the 3rd floor is 20% complete.

In section 4 - the vertical elements of the 3rd floor were concreted by 25%.

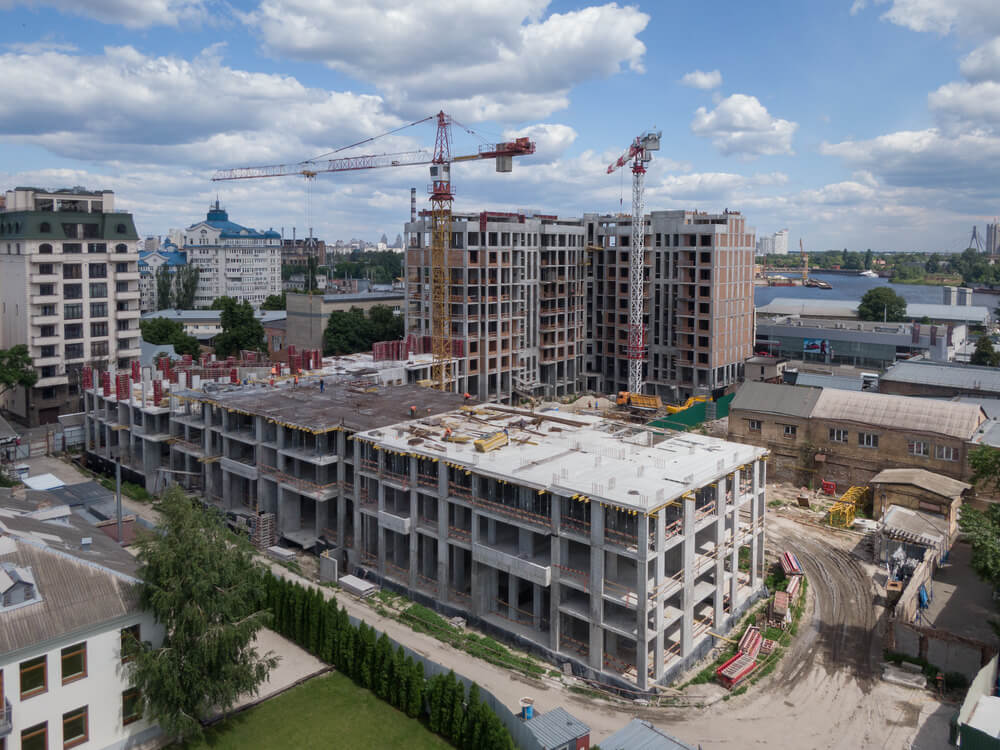

In section 5 - the monolithic work has been completed, the installation of ventilation units is in progress. The bricklaying of the 6th, 7th and 8th floors continues. We carry out the installation of the formwork of the parapets above the 2nd floor.

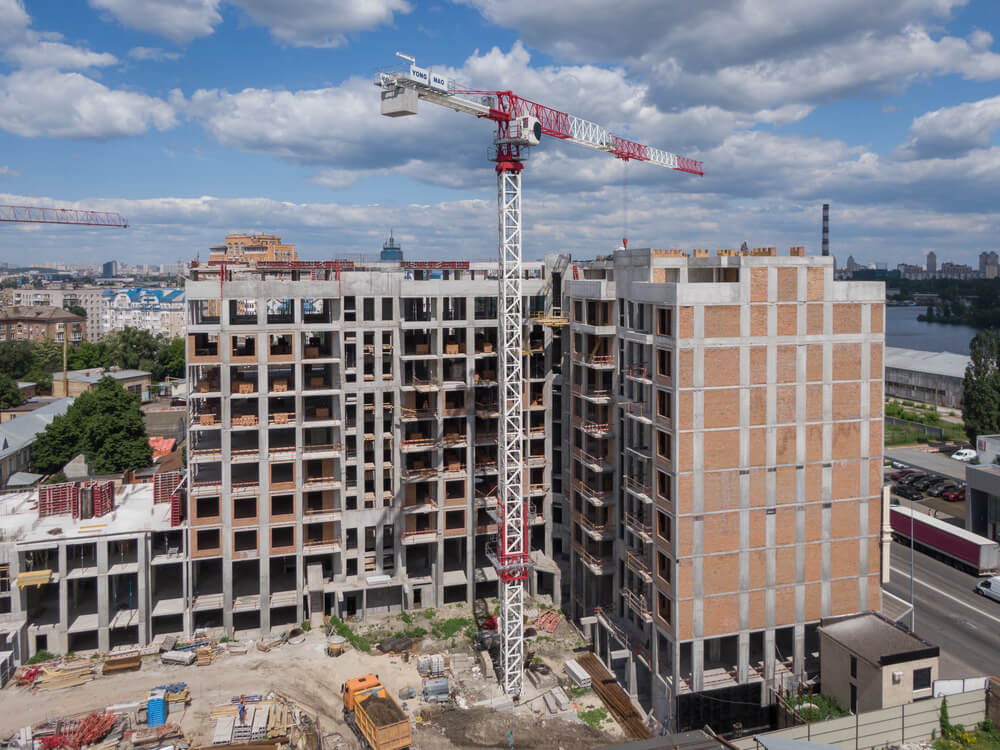

Section 6 - monolithic work completed. We lay the 6th, 7th and 8th floors with bricks. We carry out installation of ventilation units.

Section 7 - monolithic work and brickwork are fully completed. The ventilation blocks have already been brought to the roof. Roofing work is still underway.
